Missouri River Energy Services (MRES) is a South Dakota-based, community-owned, not-for-profit public power provider serving local electric utilities — not shareholders or outside investors. That means decisions are made locally, with a focus on planning for the future responsibly. When we build facilities, we own them, operate them, and remain responsive to the communities where they are located. We do not build and leave.

The proposed Toronto Power Plant is a small facility designed to keep electricity reliable for homes, farms, and businesses across the region as demand continues to grow.

About the Project:

The proposed Toronto Power Plant is a small energy facility built to provide backup electricity when it’s needed most. It would only operate during periods of high demand — such as during extreme heat or cold — when additional power is needed to keep the lights on. This is not a plant that would run around the clock like larger industrial projects in the area.

The facility’s purpose is to support the electrical needs of homes, farms, and businesses in communities such as Flandreau, Brookings, Watertown, and Big Stone City in South Dakota, as well as Marshall and Ortonville in Minnesota.

The plant would be located near Toronto, South Dakota, close to existing infrastructure to help limit new construction, reduce land impacts, and keep the overall footprint as small as possible.

FAQs

Upcoming Rezoning Ballot Question:

The June 2 election will include a ballot question about whether to rezone the land for the project site near Toronto. The Deuel County Commission approved this rezoning in April. On June 2, voters will decide whether or not to uphold the decision to rezone the property and allow the Toronto Power Plant to be built.

A “YES” vote means:

  • Rezoning is approved
  • Toronto Power Plant can be built
  • Plant is expected to:
    • Generate about $750,000 in annual taxes for local schools and services
    • Create local jobs 
    • Keep electricity reliable

A “NO” vote means:

  • Rezoning is blocked

Make your voice heard: Vote on the rezoning question in-person on Tuesday, June 2, 2026, between 7 a.m. – 7 p.m. at your regular Primary Election polling place:

  • Clear Lake Community Center
  • Toronto Community Room (Fire Hall)
  • Gary Fire Hall
  • Goodwin Fire Hall
  • Dakota Ridge Hunting & Lodge (Altamont area)
  • Brandt Community Center
  • Astoria Legion Hall

Voter Locations or contact the County Auditor if you aren’t sure where to vote.

Community Benefits:

The project would support the local economy and labor force while creating new local tax revenue each year to support public services across Deuel County. Most importantly, the plant would strengthen the regional power grid that local communities already rely on — especially during extreme weather.

According to a social and economic impact study by First District:

  • For approximately 20 months during construction, the project will create about 200 construction jobs, including a mix of general construction and skilled trade worker roles
    • This will be followed by a small number of permanent operations jobs once the facility is running, filled by people who live in the region
  • The project is expected to generate approximately $750,000 per year in property tax revenue for local governments, schools, and public services
    • Property tax rates for other landowners are expected to stabilize, supported by the expanded tax base

Community Engagement and Open Houses:

MRES will host a series of informal open houses across Deuel County to share information about the proposed Toronto Power Plant and engage in open dialogue with residents. These events are designed to provide additional opportunities for community members to ask questions and learn more about the plant’s purpose, operations and benefits.

  • Thursday, May 28
    6:00 – 8:00 p.m.
    Toronto Café, 485 Main Avenue, Toronto, S.D. 57268
  • Thursday, May 28
    6:00 – 8:00 p.m.
    Rock Room Bar & Grill, Buffalo Ridge Resort
    Gary, SD 57237
Previous Open Houses
  • Tuesday, May 19 | Open House in Clear Lake
  • Monday, May 18 | Open House in Altamont
  • Wednesday, May 13 | Community Engagement Sessions for Toronto area residents
  • Tuesday, May 12 | Open House in Gary

Ongoing Community Engagement:

MRES is committed to working closely with local leaders, landowners, and residents as this project moves forward. As a community-owned public power provider, it is our responsibility to listen, answer questions, and respond to concerns. Ongoing dialogue and community engagement will continue throughout the life of the project.

Project Status:

On April 7, 2026, the Deuel County Commission approved a rezoning requirement for the project, allowing the Toronto Power Plant to move forward at the planned location. As planning continues, we remain committed to transparency, responsiveness, and long-term partnership with the Deuel County community.

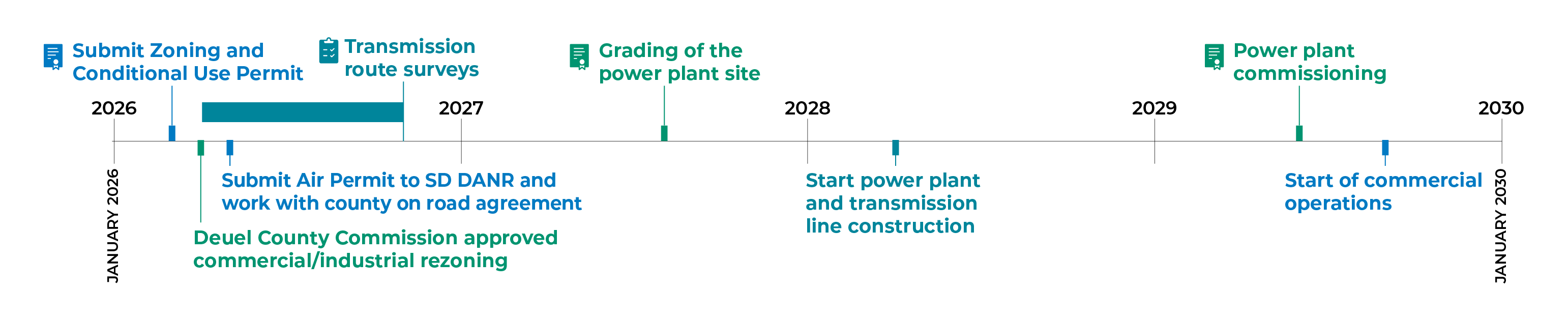

Project Milestones:

  • April 7, 2026: The Deuel County Commissioners voted to approve rezoning the property site to commercial/industrial.
  • February 26, 2026: MRES hosts a meeting with impacted area landowners.
  • September 24, 2025: The South Dakota Public Utilities Commission holds a public input meeting in Toronto, South Dakota about the project.
  • August 7, 2025: MRES submits a Facility Permit application to the South Dakota Public Utilities Commission (SD PUC) for the project.
  • November 18, 2024: The Local Review Committee (LRC) and the First District Association of Local Governments hosted an informational meeting, open to the public, to review the findings of the Social and Economic Impact Study for the proposed Toronto Power Plant.
  • June 11, 2024: MRES held a public open house to discuss the project with the community.
  • June 2024: Western Minnesota Municipal Power Agency (WMMPA) filed a Notification of Intent (NOI) with the SD PUC to apply for a permit to construct an energy conversion facility, which is the proposed Toronto Power Plant. WMMPA finances the construction and acquisition of the generation and transmission facilities for MRES.
